Section 2: QRP Process

QRP Activities

The Central Planning team consists of 5 Divisions: TPP, ROW, ENV, PEPS, and FIN. These Divisions meet to consolidate the project portfolios provided by all 25 districts into a consolidated, or central, portfolio. See Figure 8-2.

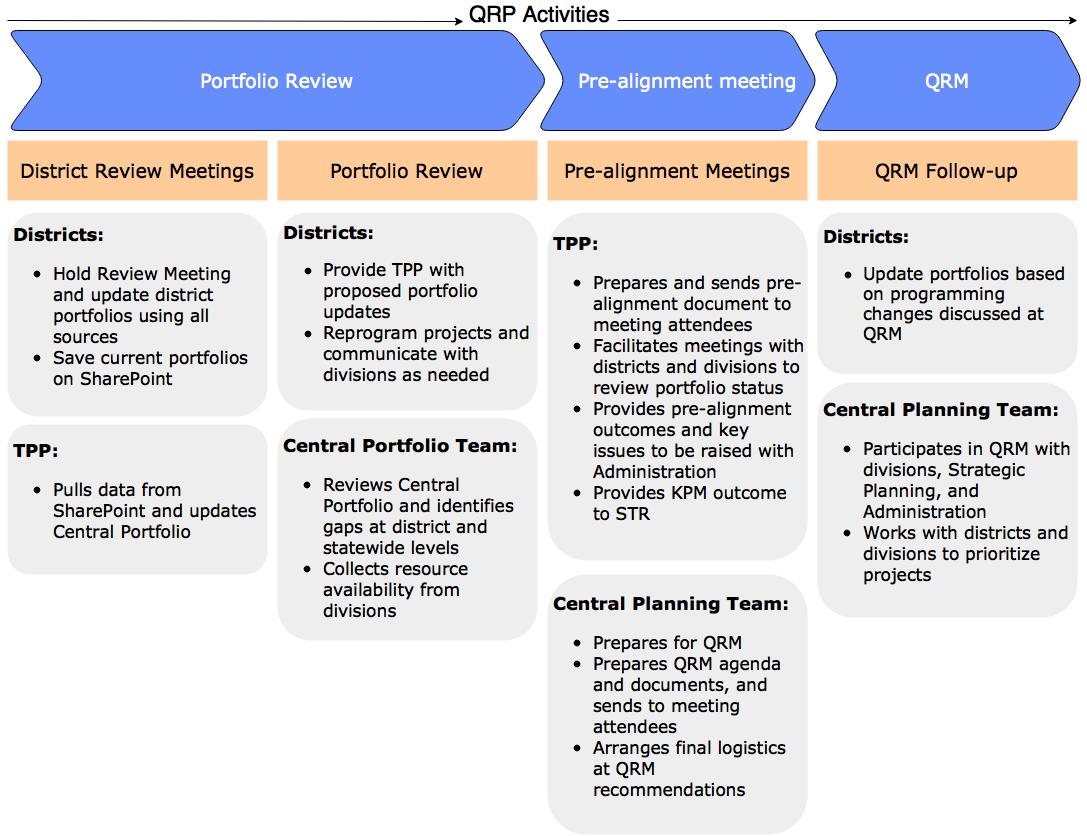

QRP Activities (click in image to see full-size image)
Figure 8-2. QRP Activities

QRP Outcomes

The QRP enables achievement of the four outcomes listed in Figure 8-3 through regular coordination among all stakeholders.
QRP Outcomes (click in image to see full-size image)
Figure 8-3. QRP Outcomes
Each QRP phase will culminate in an associated Quarterly Review Meeting (QRM) with TxDOT Administration. Each QRM will be preceded by many District Review Meetings and a pre-alignment meeting to assist districts with prioritizing projects and facilitating the efficient delivery of the District Portfolio. Figure 8-4 shows where QRP fits within the other process improvement initiatives.
QRP and the Planning Process (click in image to see full-size image)
Figure 8-4. QRP and the Planning Process

Roles & Responsibilities and Critical Path

TxDOT ADM, divisions, and districts are all critical to the success of the QRP. Figure 8-5 lists some of the key activities associated with each TxDOT stakeholder.

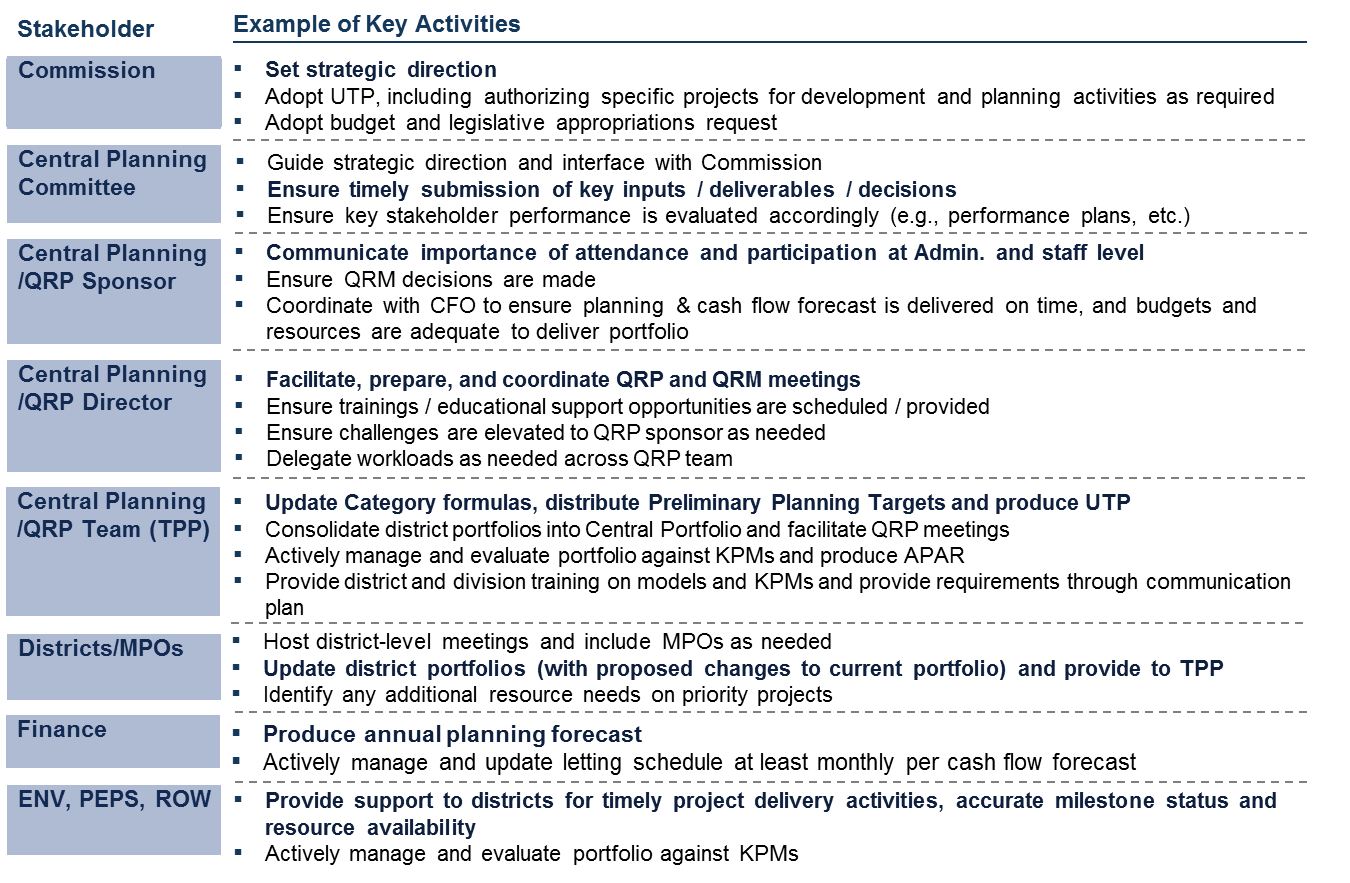

Stakeholder Roles and Responsibilities (click in image to see full-size image)
Figure 8-5. Stakeholder Roles and Responsibilities
ENV = Environmental Affairs Division; PEPS = Professional Engineering Procurement Services Division; and ROW = Right of Way Division.

Critical Path

8-6 through 8-11 show the quarterly review process.

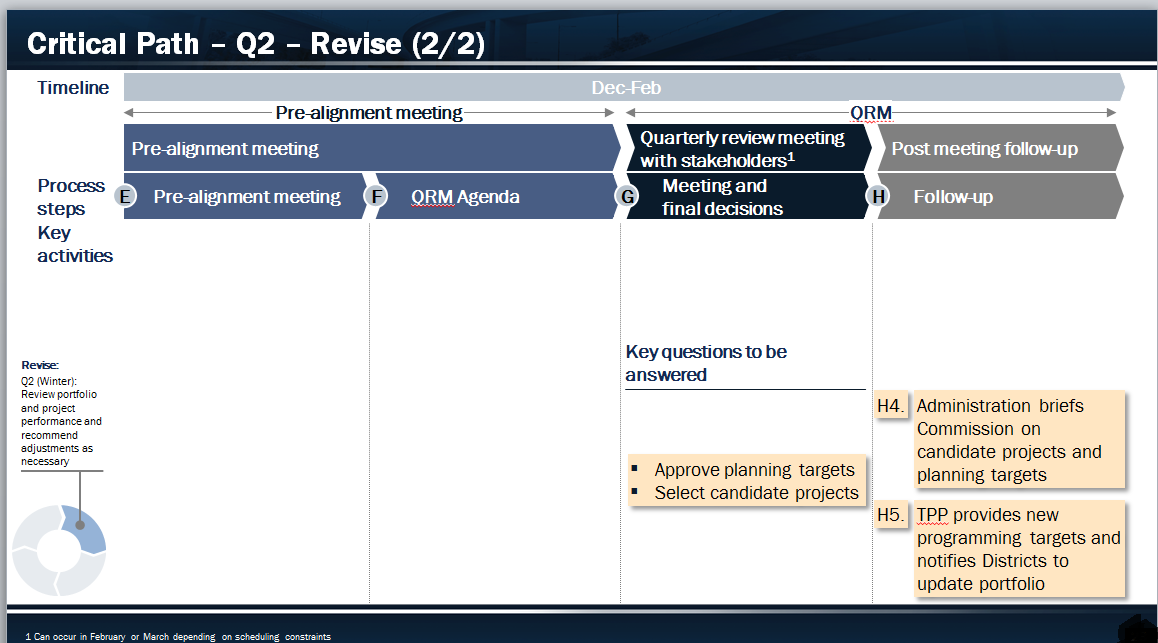

QRP Second Quarter Activities A-D (click in image to see full-size image)
Figure 8-6. QRP Second Quarter Activities A-D
QRP Second Quarter Activities E-H (click in image to see full-size image)
Figure 8-7. QRP Second Quarter Activities E-H

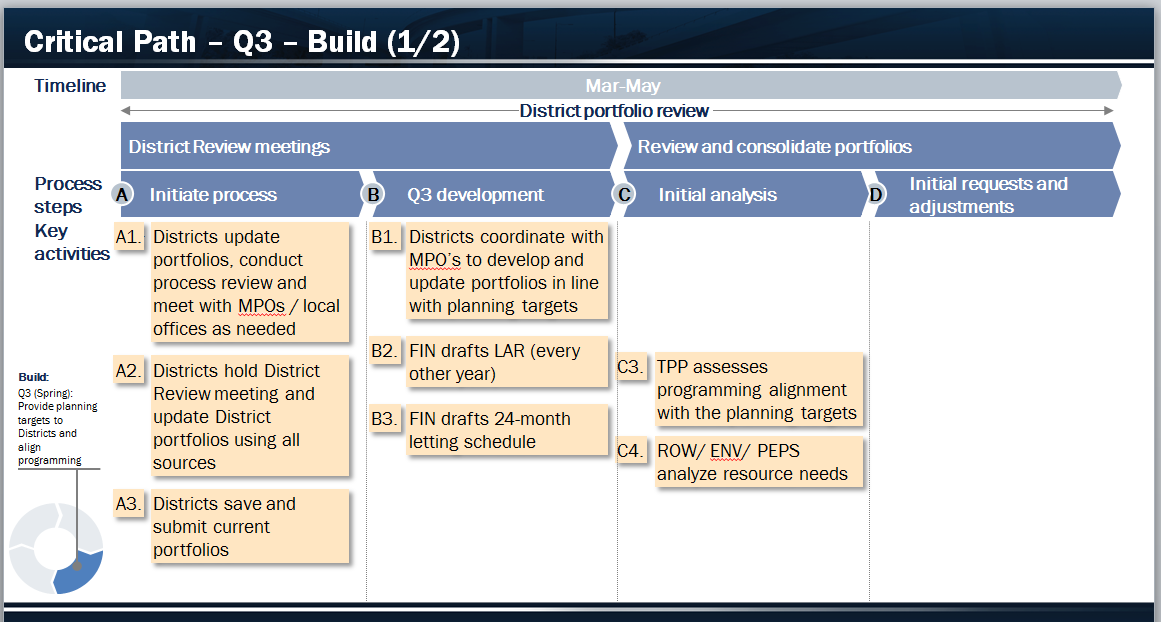

QRP Third Quarter Activities A-D (click in image to see full-size image)
Figure 8-8. QRP Third Quarter Activities A-D
QRP Third Quarter Activities E-H (click in image to see full-size image)
Figure 8-9. QRP Third Quarter Activities E-H

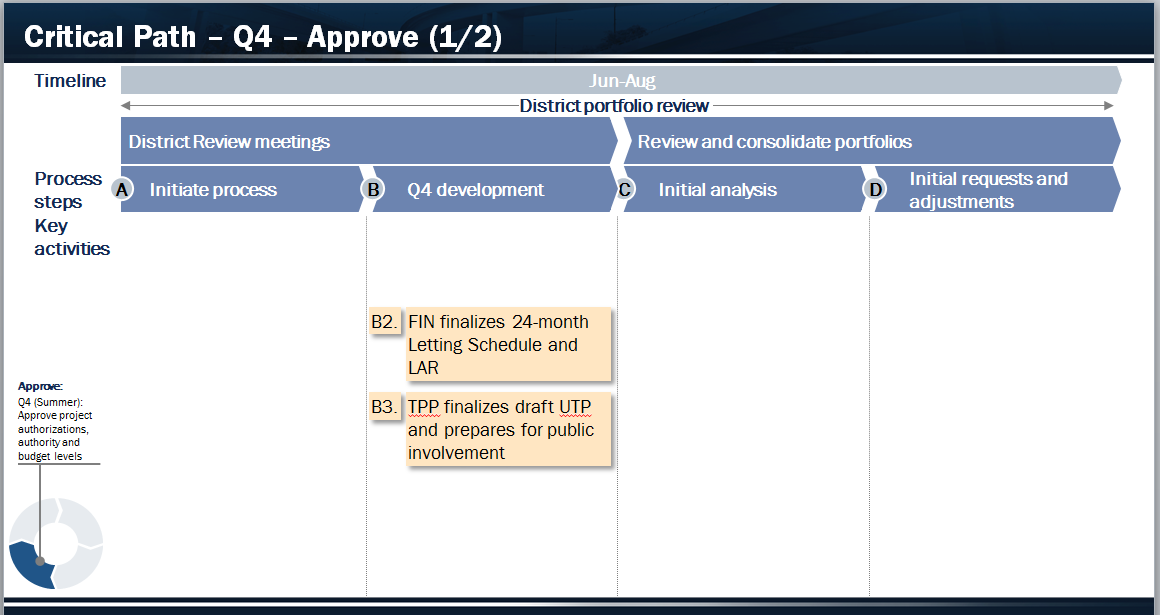

QRP Fourth Quarter Activities A-D (click in image to see full-size image)
Figure 8-10. QRP Fourth Quarter Activities A-D
QRP Fourth Quarter Activities E-H (click in image to see full-size image)
Figure 8-11. QRP Fourth Quarter Activities E-H

Where to Find More Information

Visit the home page and enroll in the TPD series of training (see Table 8-1). If you have any questions or need assistance, please email or call the Training Hotline at (512) 416-2000.
Table 8-1 TPD Training
Class Code
Course Name
TPD101
Overview of Project Development & Delivery at TxDOT
TPD102
Project Delivery & Governance (PD&G)
TPD103
Performance Based Planning (PBP)
TPD104
Quarterly Review Process (QRP)
QRM and Pre-Alignment meeting information is also located at the (for internal users).
