Section 3: Steps to Approve a Substitution Request in DMS

Prime contractors can submit a substitution request via DMS. The District can either accept or deny the request.

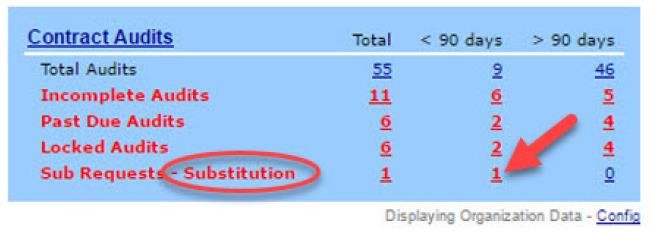

If your dashboard is configured to display the
Contract Audits
, there will be a number in red that appears any time there is a
Sub Requests - Substitution.

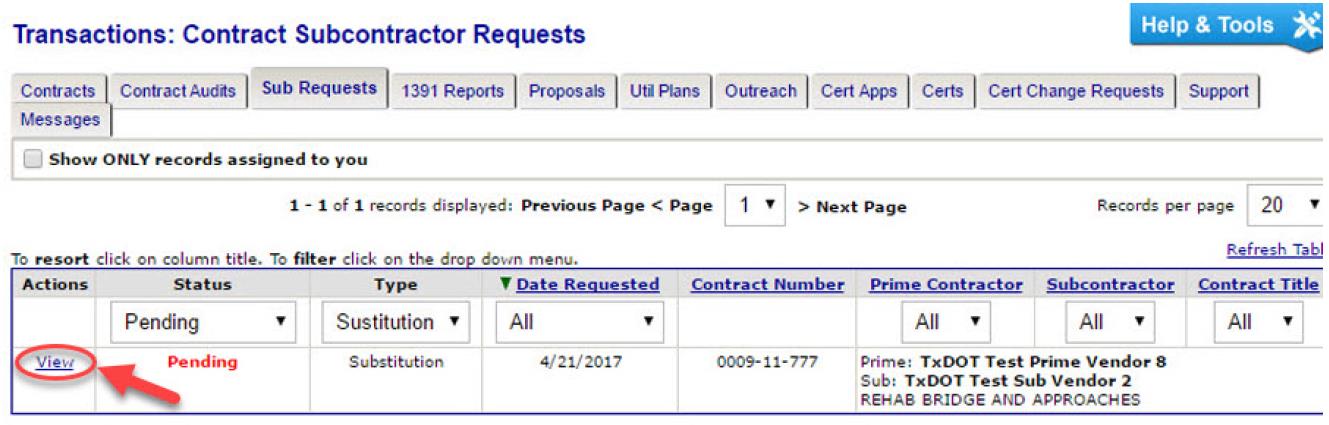

If you are selecting the Sub Requests - Substitution from this shortcut on your dashboard, proceed to
Step 3
below:
 (click in image to see full-size image)
If you do not see the
Sub Requests
on the dashboard, begin at
Step 1
below:
Step 1:
Log in to DMS.
Step 2:
To access subcontractor requests from the navigation menu, open the
View
menu and then click
Sub Requests
.
Step 3:
Click
View
.
 (click in image to see full-size image)
Step 4:

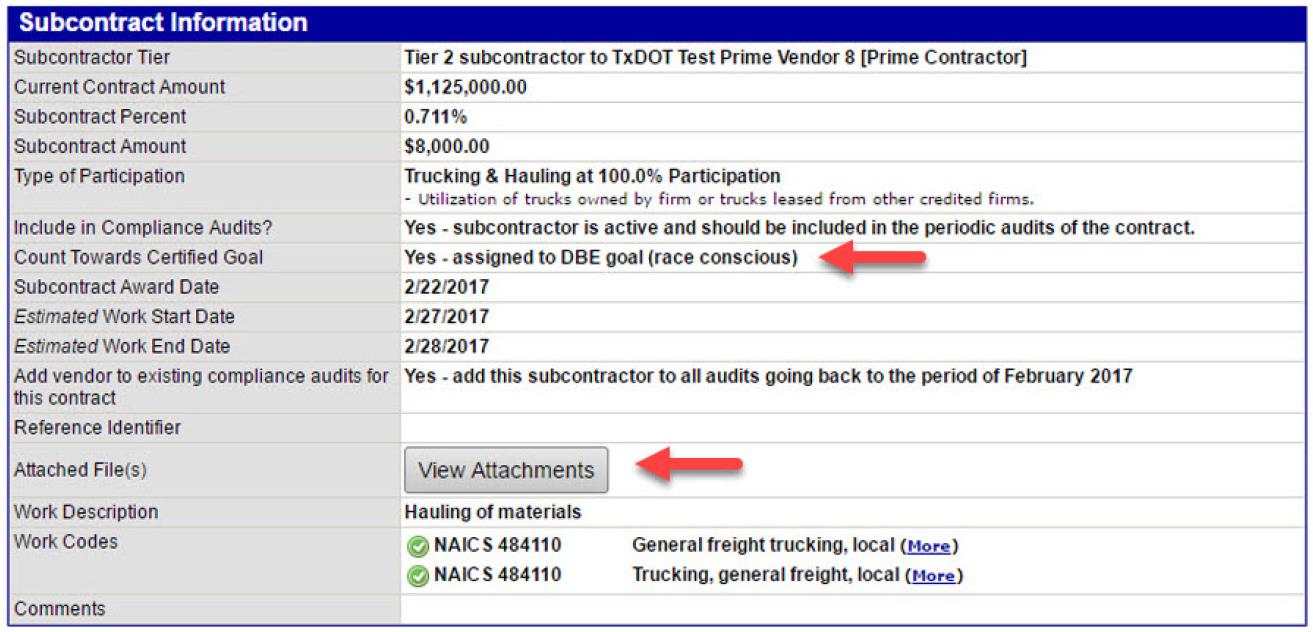

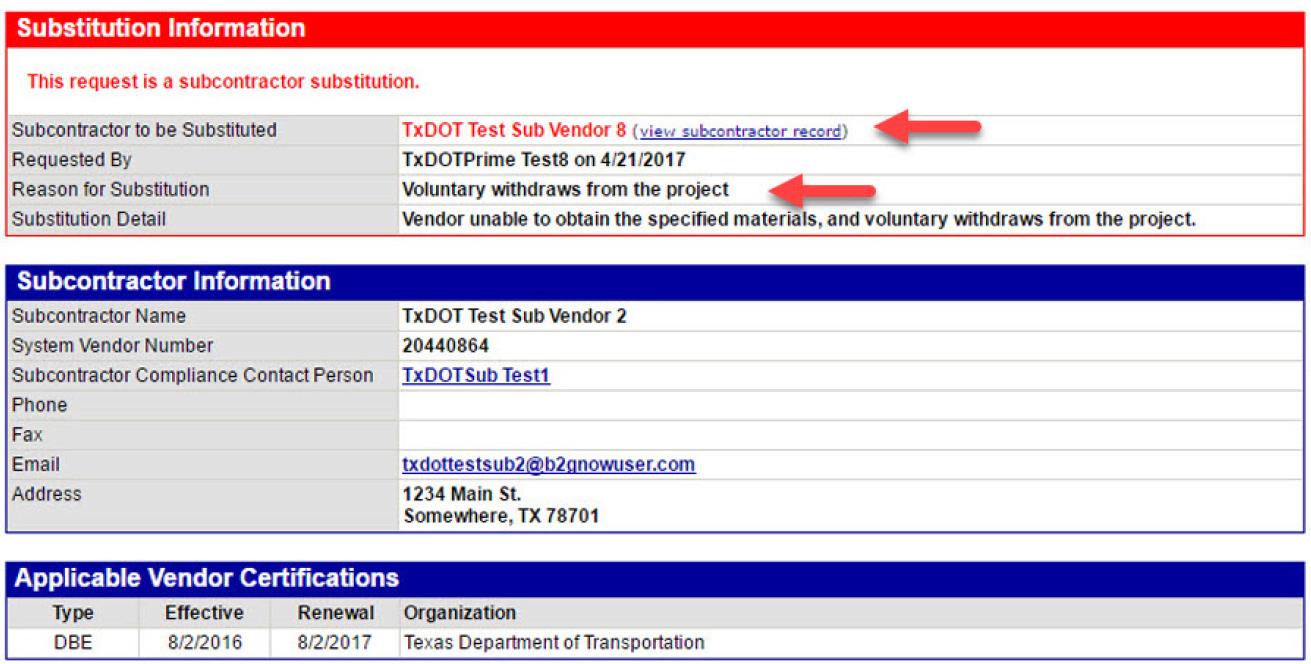

Review the request to verify good cause. See additional guidance in Section 1 of this chapter. View Attachments as necessary.
 (click in image to see full-size image)
 (click in image to see full-size image)
 (click in image to see full-size image)

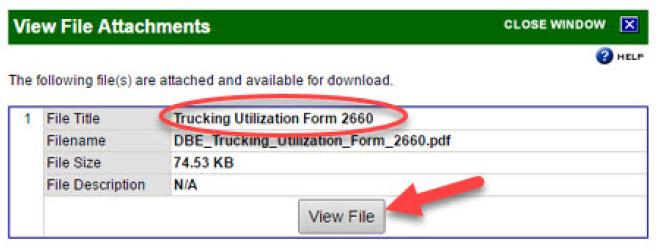

Sample Attachment (click in image to see full-size image)
Figure 18-1. Sample Attachment
Note:

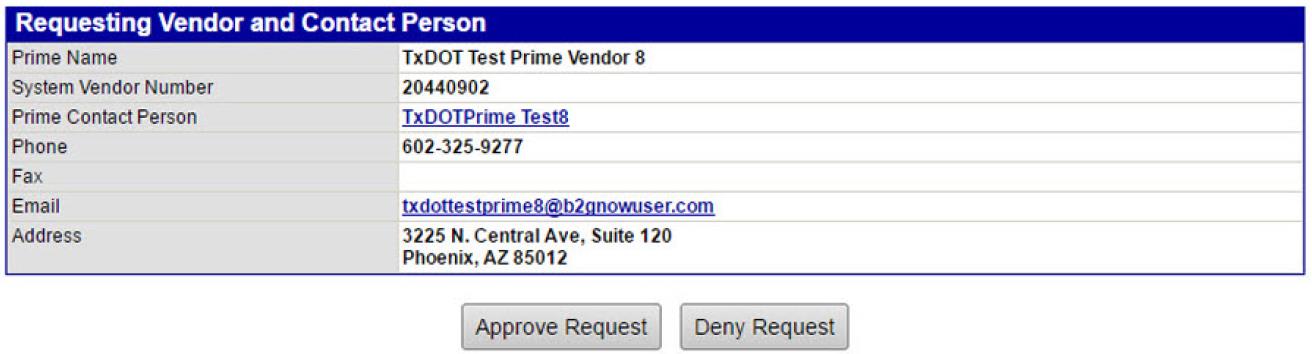

If

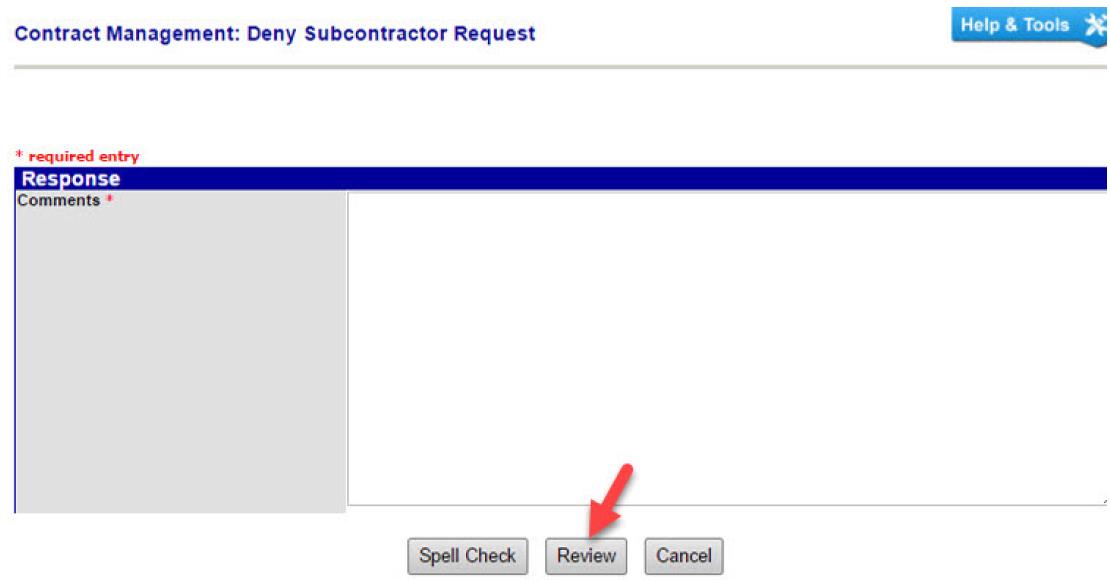

Deny Request
is selected, the district staff will need to provide comments. Click
Review
and then
Save
.
 (click in image to see full-size image)
Step 5:

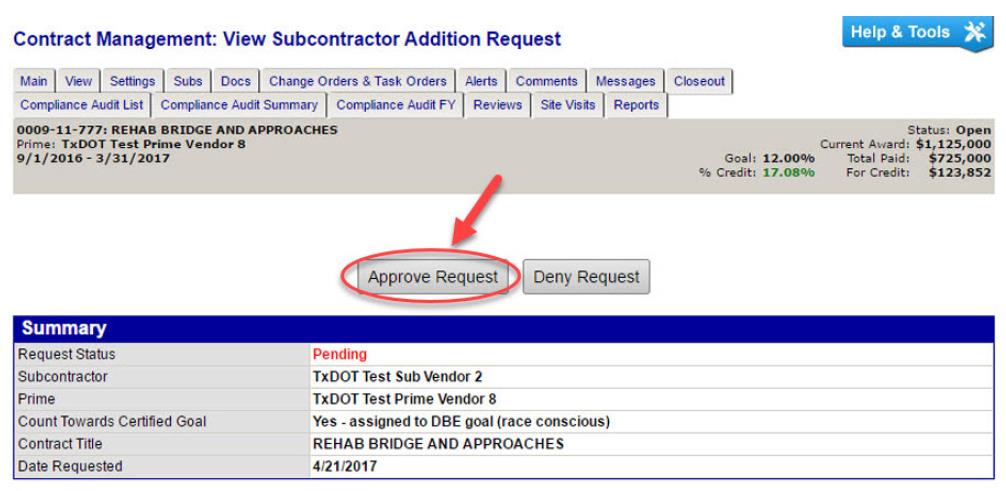

If
Approve Request
is selected continue to Step 6.
 (click in image to see full-size image)
Step 6:
Click
OK
to confirm you want to navigate to the next page to review and confirm the request.

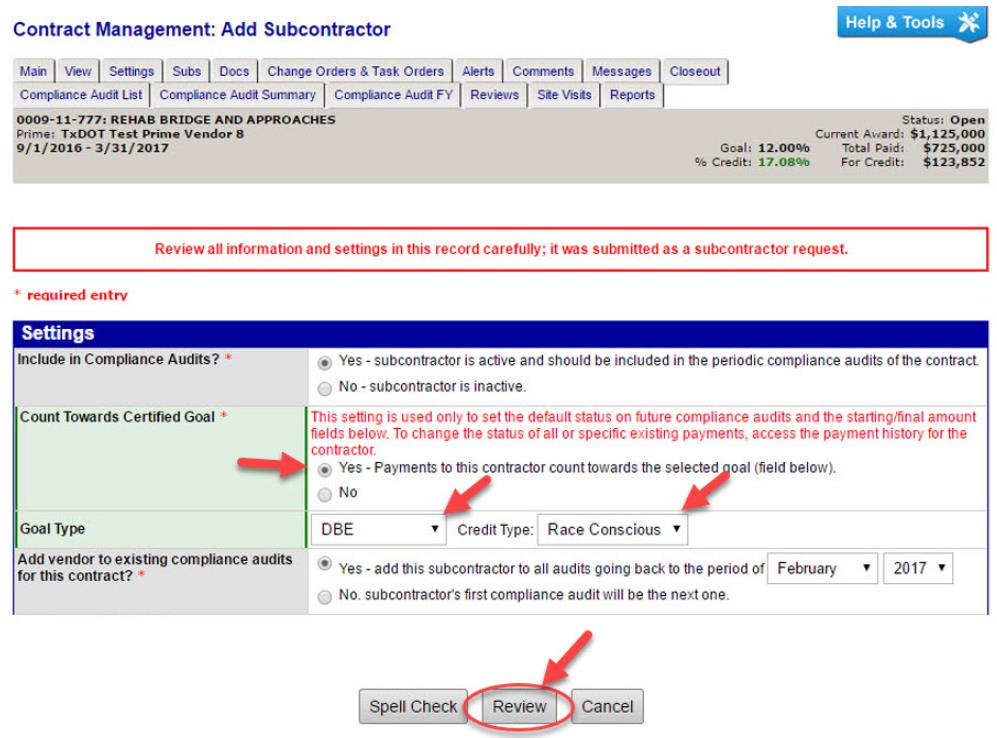

Step 7:

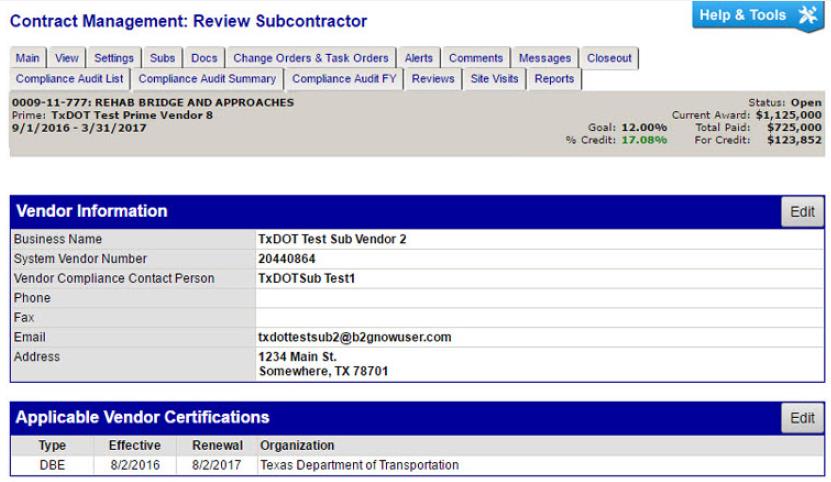

Verify Information is correct on the
Add Subcontractor
page, then click
Review
.
 (click in image to see full-size image)

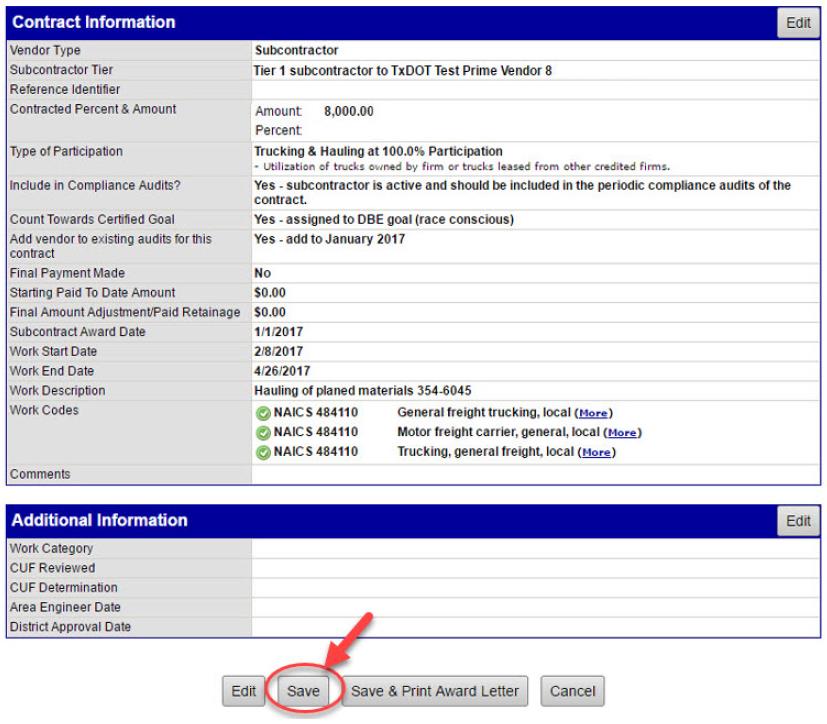

Step 8:
Review information and click
Save
.
 (click in image to see full-size image)
 (click in image to see full-size image)
