Unpaid Retainage

The retainage is usually indicated by the subcontractor during the monthly audits. If the subcontractor did not indicate retainage for the monthly audits and it is necessary, the district staff can edit the subcontractor from the
Subs
tab of the contract and enter the retainage amount in the field:
Final Amount Adjustment/Paid Retainage
.
Follow the below process if there is unpaid retainage on a project.
Step 1:

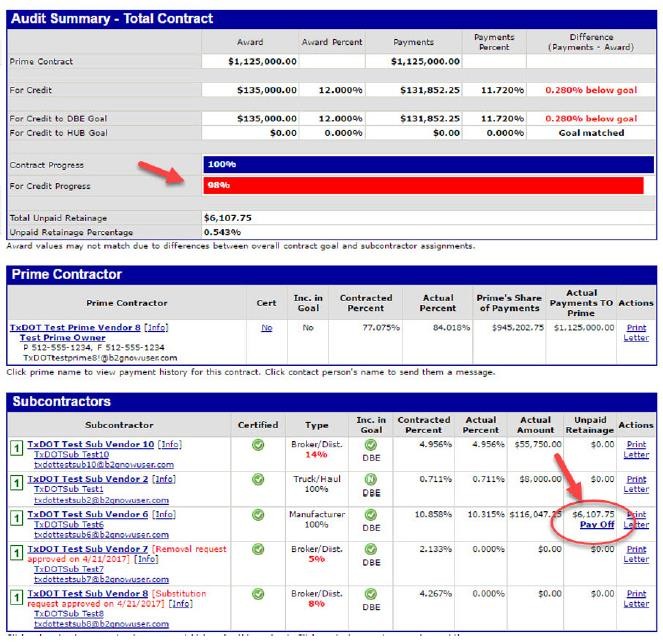

Note the Goal Shortfall and Unpaid Retainage amounts remaining for each subcontractor. Click
Pay Off
.
 (click in image to see full-size image)
Step 2:
Click OK.
Step 3:

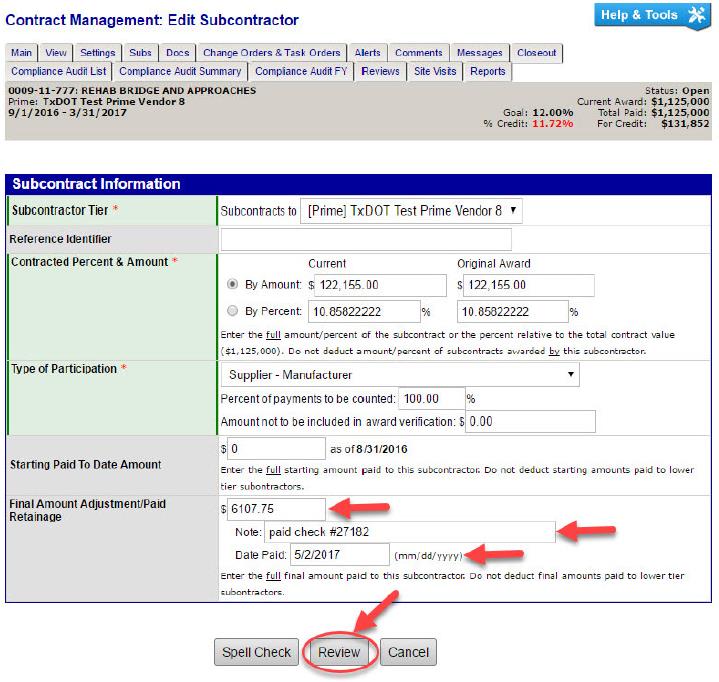

On the Edit Subcontractor Page, under the Subcontract Information Box, enter unpaid retainage amount into the Final Amount Adjustment/Paid Retainage Box.
Note:
Enter Retainage only.
Step 4:
Click Review.
 (click in image to see full-size image)

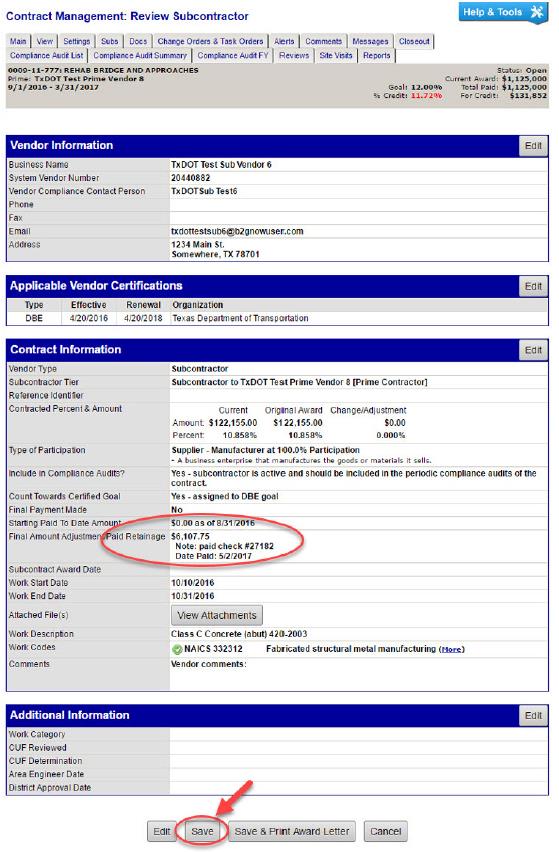

Step 5:
Review and
Save
.
 (click in image to see full-size image)
Step 6:
Continue the Closeout process at
Step 5
of the previous subsection.
Note:

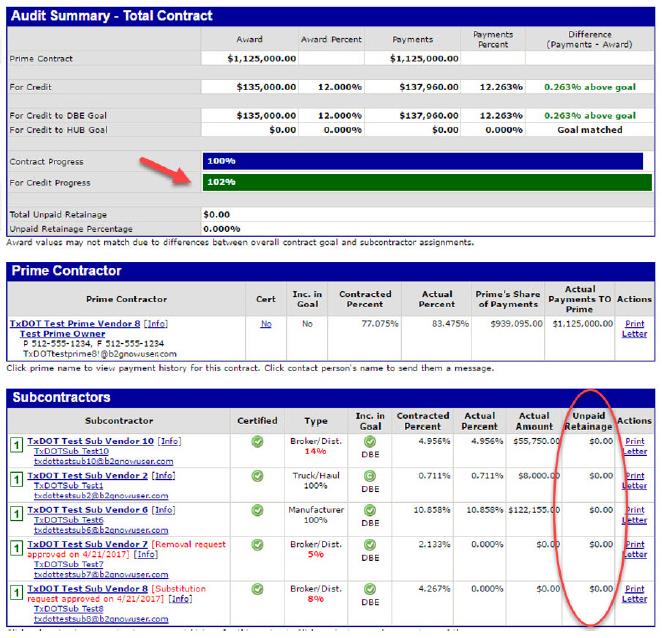

In this example the goal shortfall is satisfied after unpaid retainage is entered.
 (click in image to see full-size image)
