Section 3: When the Prime Contractor is a DBE

Overview

If a prime contractor is a DBE, the contract must be updated to reflect this status. The system tracks payments of DBE prime contractors using the following method.

Calculated Remaining Amount

Payments to the DBE prime contractors are calculated as the remaining amount after payments are made to all DBE and non-DBE subcontractors. This method requires that all subcontractors are tracked. For example:

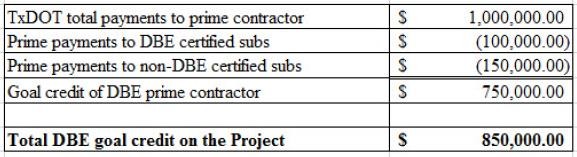

 (click in image to see full-size image)

Edit Prime Contractor to Count Towards DBE Goal

Step 1:
Log in to DMS.
Step 2:
Locate desired contract and navigate to
Contract Management
page.
Step 3
: Click the
Subs
tab.
Step 4:
In the Prime Contractor area, in Action box, click
Edit
.

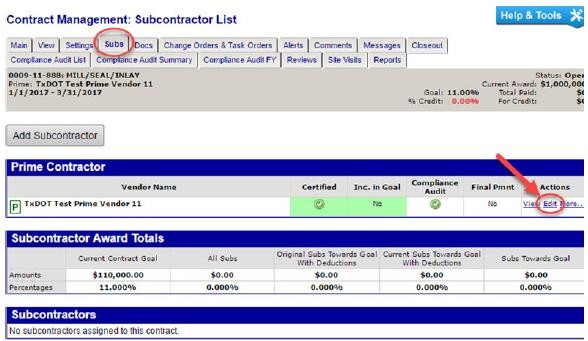

 (click in image to see full-size image)
Step 5:
On the Contract Management: Edit Prime Contractor page, change the
Count Towards Certified Goal
to Yes.
Step 6:
Select
Goal Type as DBE
.
Step 7:
Select
Credit Type
as Race Conscious.
Step 8:
Assign Work Codes.
Step 9:
Click

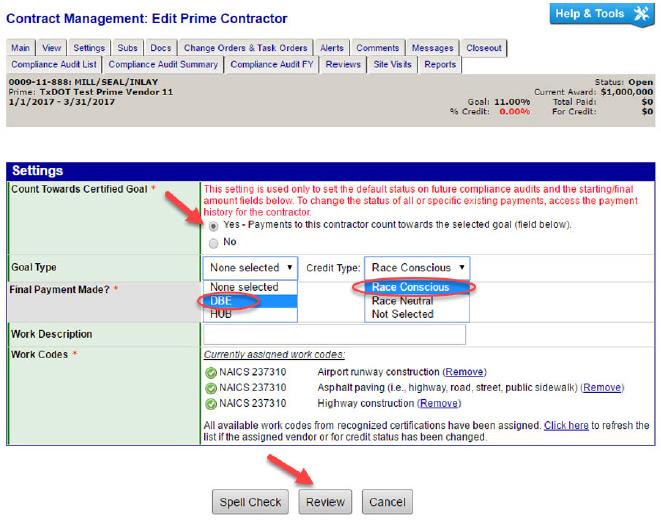

Review
.

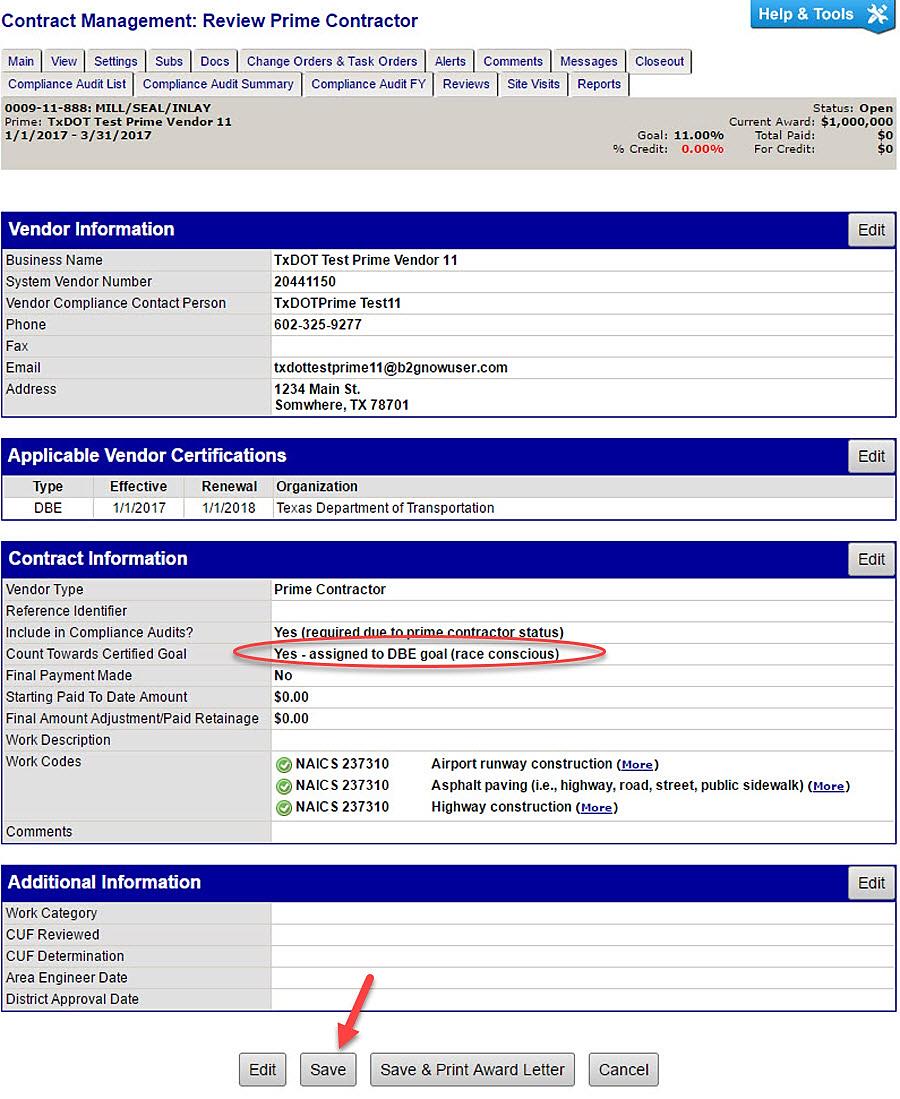

 (click in image to see full-size image)
Step 10:
Review edits to Prime Contractor Settings and click
Save
.
 (click in image to see full-size image)

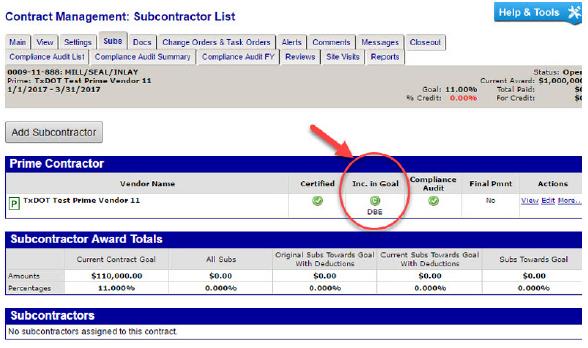

Note: The Prime Contractor box under theSubs tab will reflect that the prime is counted for credit. (click in image to see full-size image)
Figure 9-1. Note: The Prime Contractor box under the Subs tab will reflect that the prime is counted for credit.
Step 11:
After “Locking In” the contract, the DBE prime contractor should be notified to add all DBE and non-DBE subcontractors.

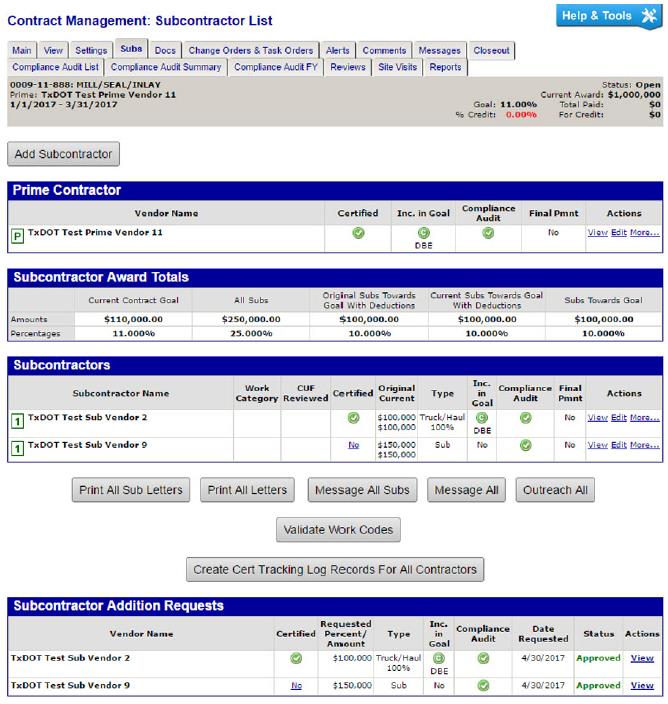

The image above shows the Subs tab afterthe prime contractor has added subcontractors and district staffhave approved the sub requests. (click in image to see full-size image)
Figure 9-2. The image above shows the Subs tab after the prime contractor has added subcontractors and district staff have approved the sub requests.
