Section 2: Locking in Contract Records in DMS
Overview
Each contract will be imported into the DMS system via an
automated process. It is the responsibility of the District to review
that the contract details have been entered correctly. The contract settings
should not be changed unless CIV staff is consulted.

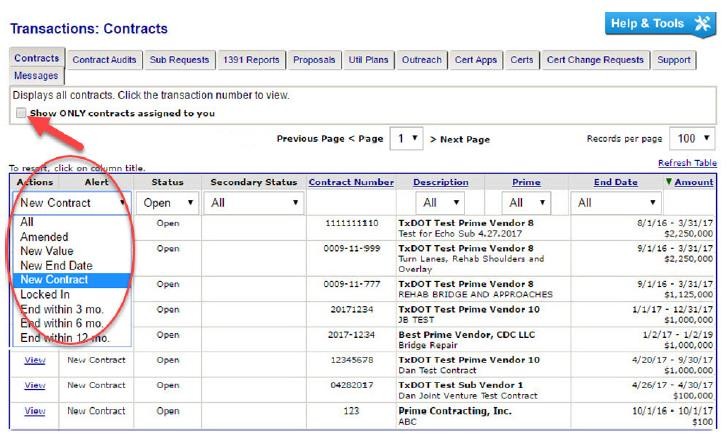

To View All New Records
Step 1

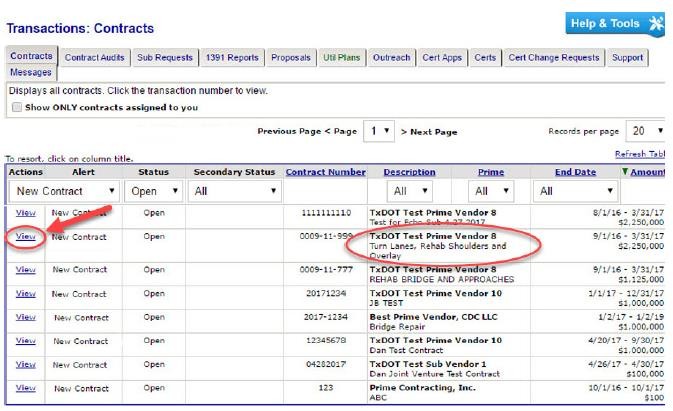

: From the View Menu, click Contracts.Step 2
: From the Actions list, select New Contract./assets/Chapter-9/Section-2/new_contract.jpg/_jcr_content/renditions/cq5dam.web.1280.1280.jpeg)
Locking In New Contract Records
Step 1:
Click View
to view the associated contract record./assets/Chapter-9/Section-2/view_contract.jpg/_jcr_content/renditions/cq5dam.web.1280.1280.jpeg)
Step 2
: Click Review Contract
. (An alert displays to provide instructional information.) Note: All contract alerts are displayed in red. If the contract is a new record, the alert “Contract record is new and must be reviewed for accuracy” will be listed.
/assets/Chapter-9/Section-2/contract_alerts.jpg)
Step 3:
Click OK

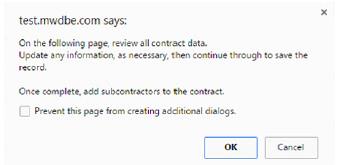

(The contract edit page displays with the contract header data from the import auto-filled into the fields. Many fields will be blank or zero.)/assets/Chapter-9/Section-2/contract_data_msg.jpg)
Step 4:
Review the entire record and update as needed. When finished, click Review at the bottom of the page. When reviewing the data, do the following: - Verify Contract title/description
- Verify CSJ
- Verify Value of contract
- Verify (and change if necessary) (Projected) End Date
- Verify Prime Contractor Information
- Verify (and change if necessary) Buyer/Project Manager (in-system user)
- Verify DBE Goal
- Add funding sources and amount (important for DBE FHWA funded projects)

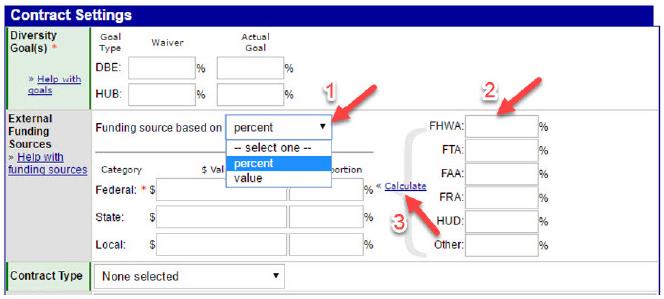

CIV will post the Federal Contract Update Report in SharePoint, which will include the project CSJ and corresponding percentage of federal funding. Use the information to complete the following:
- SelectPercentagefrom the Funding source based on dropdown menu.
- Enter the percentage amount from the Federal Contract Update Report in the FHWA field.
- Click theCalculatelink.
/assets/Chapter-9/Section-2/contract_settings.jpg)
- Verify subcontractor settings
Do not adjust default settings.

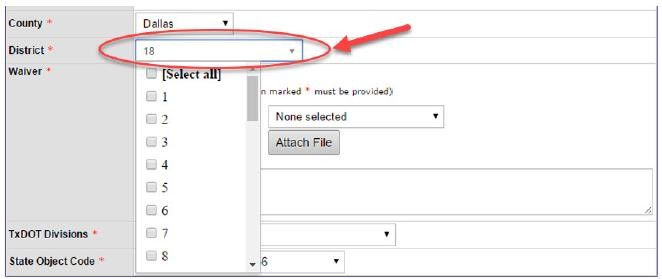

- Select the appropriateCounty.
/assets/Chapter-9/Section-2/district_number.jpg/_jcr_content/renditions/cq5dam.web.1280.1280.jpeg)
- Select theCongressional District of the State of Texasnumber where the project resides. (Multiple selections are allowed if the project encompasses multiple Districts)
- Verify Waiver information
- Select the appropriateTxDOT Division.
- Select the appropriateState Object Code.
- Adjust audit settings (as necessary for DBE prime contractors)
- Verify Contract compliance officer is correctly assigned.
- Add notes (if necessary)
- Attach electronic documentation
Step 5:
Click Review
to review the contract. (Click Edit
to make further changes, if needed) Step 6:
To save the record, click Save
.Step 7:

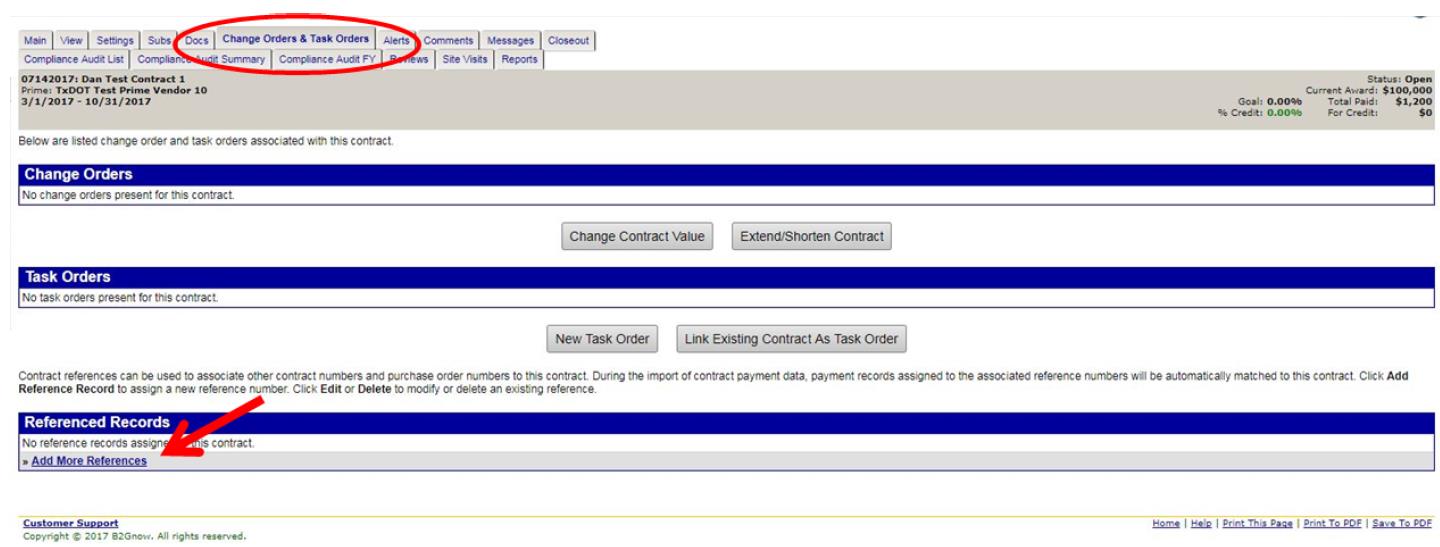

Select the Change Orders & Task Orders
tab. Click Add More References
./assets/Chapter-9/Section-2/change_task_orders.jpg)
Step 8:

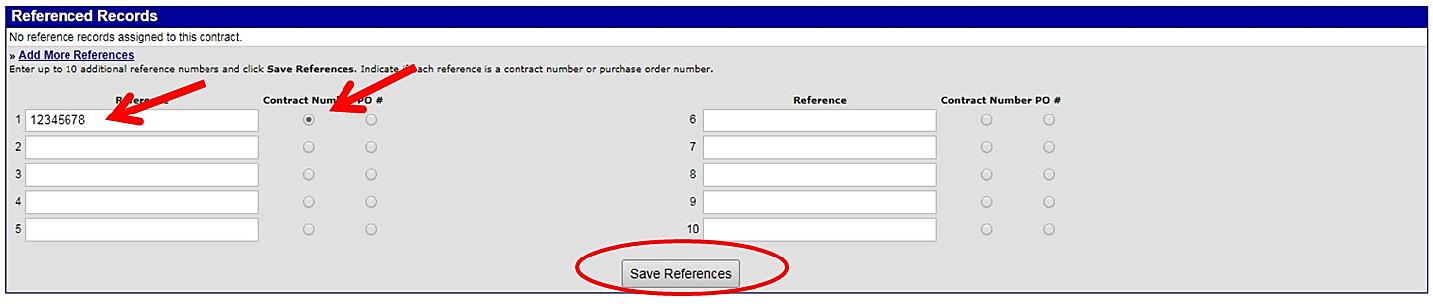

Enter the CSJ and select Contract Number
. Click Save References
./assets/Chapter-9/Section-2/contract_num_save.jpg)
